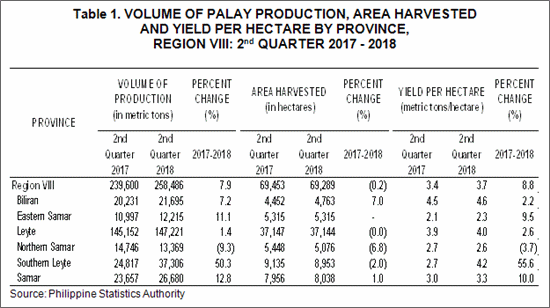

Second quarter
			palay production in Eastern Visayas increases by 7.9%
			By
			PSA-8
			August 17, 2018

TACLOBAN CITY –
			Palay production in Eastern Visayas increased by 7.9 percent, from
			239,600 metric tons (MT) in the second quarter of 2017 to 258,486 MT
			in the second quarter of 2018. Increases were observed among all
			provinces, except in Northern Samar, which posted a decrease of
			9.3%. Southern Leyte recorded the highest increase in production of
			50.3%, from 24,817 in the second quarter of 2017 to 37,306% in the
			second quarter of 2018.
			Among the provinces, Leyte
			produced the highest volume of palay at 147,221 MT, which comprised
			more than half (57.0%) of the total palay production in the region.
			Eastern Samar, meanwhile, had the lowest volume of production
			(12,215 MT) accounting for only 4.7%.
			The total harvest area for
			palay in the region decreased slightly by 0.2%, from 69,453 hectares
			in the second quarter of 2017 to 69,289 hectares in the second
			quarter of 2018. Increases recorded in Biliran (7.0%) and Samar
			(1.0%) were offset by the decreases registered in Northern Samar
			(6.8%) and Southern Leyte (2.0%).
			Leyte recorded a little
			over half or 53.6% (37,144 hectares) of the total palay area
			harvested during the quarter in review, while Biliran contributed
			the least (4,763 hectares) accounting for only 6.9%.

			Yield per hectare for
			palay in the region went up by 8.8%, from 3.4 MT per hectare in the
			second quarter of 2017 to 3.7 MT per hectare in the same quarter of
			2018.
			Among the provinces,
			Biliran posted the highest yield per hectare during the quarter in
			review at 4.6 MT per hectare. Eastern Samar registered the lowest
			yield per hectare at 2.3 MT per hectare.

					|

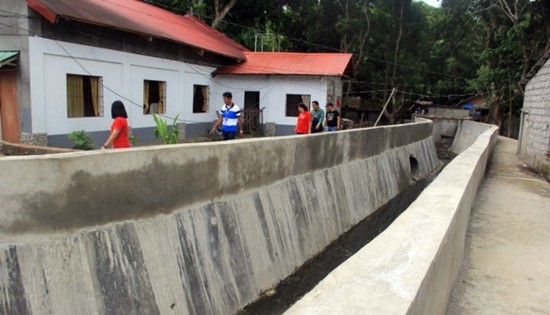

					The
					Inspectorate Team of DPWH Samar I conducts a final
					inspection of the flood control structures along Bantian
					creek, Brgy. Bantian, Calbayog City.  |

			P10-M flood
			control along Bantian Creek completed
			By
			JASON DELOS ANGELES
			August 17, 2018
			CALBAYOG CITY – As
			part of the Build Build Build Program of the present
			administration, the Department of Public Works and Highways Samar
			First District Engineering Office (SFDEO) completes the
			rehabilitation and improvement of the flood control project along
			Bantian Creek, Brgy. Bantian, Calbayog City.
			The project covers the
			construction of 96 meters of flood mitigating structures in addition
			to the already existing flood control project along the creek. It is
			under contract with JFR Construction with an appreciation of P10
			million sourced out from the 2018 General Appropriations Act (GAA)
			Fund.
			The flooding in Brgy.
			Bantian brought about by the monsoon rain affects so much of their
			residents’ properties. During the last flood, their barangay hall
			got flooded and even elevated houses were not spared.

			The existing flood control
			project can no longer accommodate the volume of water overflow
			caused by heavy rainfall, especially during typhoon season. It also
			worsened during high tides because the creek is connected to Samar
			Sea.

			The rehabilitation and
			improvement of this flood control project has a widened catchment
			that can now accommodate an even higher volume of water capacity.

			With this, flooding is not
			only mitigated but prevented.

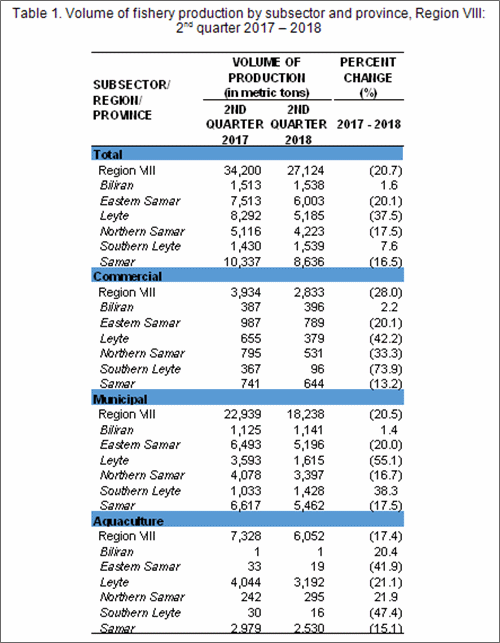

			Q2 fishery
			production in Eastern Visayas drops by 20.7%
			By
			PSA-8
			August 17, 2018
			TACLOBAN CITY –
			Fishery production in Eastern Visayas dropped by 20.7% from 34,200
			metric tons (MT) in the second quarter of 2017 to 27,124 MT in the
			second quarter of 2018.
			All provinces registered
			decreases in fishery production, except Biliran and Southern Leyte,
			which recorded increases of 1.6% and 7.6%, respectively from their
			levels of production in the same quarter in 2018. Leyte recorded the
			highest decrease of 37.5%, from 8,292MT in the second quarter of
			2017 to 5,185 MT during the quarter in review.
			Among provinces, Samar
			produced the highest volume of fishery production at 8,636 MT, which
			comprised 31.8% of the total fishery production in the region.
			Eastern Samar ranked second with 6,003 MT, which accounted for 22.1%
			of the region’s total fishery production. Biliran, meanwhile
			registered the lowest volume of production with 5.7% share or 1,538
			MT.
			By subsector, volume of
			production in Commercial Fishing went down by 28.0%, from 3,934 MT
			in the second quarter of 2017 to 2,833 MT in the same period in
			2018. All provinces registered decreases, except Biliran, the only
			province that recorded a slight increase of 2.2%. Southern Leyte
			recorded the highest decrease of 73.9%, from 367 MT in the second
			quarter of 2017 to 96 MT during the quarter in review.
			Similarly, volume of
			production in Municipal Fishing (marine and inland) registered a
			decrease of 20.5%, from 22,939 MT in the second quarter of 2017 to
			18,238 MT in the same quarter in 2018. All provinces registered
			decreases, except Biliran and Southern Leyte, which posted increases
			of 1.4% and 38.3%, respectively. Leyte registered the highest
			decrease in volume of production at 55.1%.
			Volume of production in
			Aquaculture also declined by 17.4%, from 7,328 MT in the second
			quarter of 2017 to 6,052 MT in the same period in 2018. Among
			provinces, only Biliran and Northern Samar registered growths in
			production of 20.4% and 21.9%, respectively. However, the increases
			were negated by the decreases recorded by Eastern Samar (41.9%),
			Leyte (21.1%), Southern Leyte (47.4%) and Samar (15.1%).
			About two-thirds or 67.2%
			(18,238 MT) of the total fishery production in the region were from
			Municipal Fishing. Aquaculture contributed 22.3% (6,052 MT), while
			Commercial Fishing accounted for 10.4% (2,833 MT).

					|

					P18.5M
					construction/extension of flood control structure along
					Mapula river protecting Mapula bridge and Biliran circum
					road, Biliran, Biliran Province is 100% completed as of July
					31, 2018. This project is in contract with YOYEN
					Enterprises. The completed project will prevent flooding on
					the said area protecting not only the bridge but the
					surrounding agricultural lands.  |

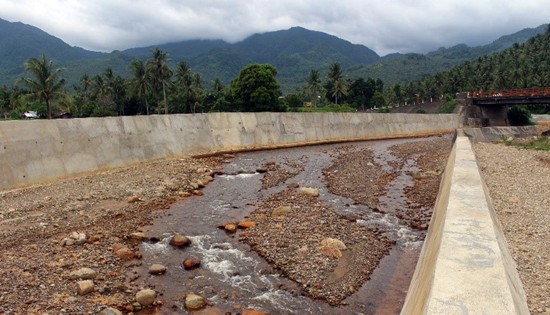

			DPWH-Biliran DEO
			completes 13 flood control projects in Biliran
			Press Release
			August 15, 2018
			NAVAL, Biliran –
			Following the department’s new approved plans and specifications for
			flood mitigation structures, District Engineer David P. Adongay Jr.
			assures quality implementation for completed flood control projects
			in Biliran.
			The Department of Public
			Works and Highways (DPWH) Biliran District Engineering Office (BDEO)
			has a total of 18 flood control projects this year amounting to
			P371.5M under the Flood Management Program.
			Out of the 18 flood
			control projects, the district office has completed 13 and eyeing
			for the completion of 5 more for the next two months.
			According to Adongay, the
			previous design of flood control is no longer the same as the design
			of the district office at present.
			“We have already an
			additional reinforcing bars on the revetment side designed to
			protect from flooding,” said Adongay.
			Recalling tropical storm
			Urduja last year that badly hit almost the entire province, Adongay
			said that district’s new design of flood control projects have
			withstand against major flooding.
			“Based on our experience,
			yung mga bagong design hindi nasira nung Urdjua, pero depende rin sa
			river at lugar kasi merong lugar na binaha pero walang kasamang
			debris,” Adongay explained.
			Adongay further added that
			the goal of these flood control projects is to ensure safe
			environment through these facilities, leading economic growth
			towards poverty reduction.
			“As regards the completed
			flood control projects in the province, these are important
			infrastructure projects to the populace and community as their lives
			and properties are protected against major floods,” said Adongay.
			The completed flood
			control projects are located along the rivers of Bagongbong in
			Almeria, Busali and Santol in the Municipality of Biliran, Esperanza
			in Cabucgayan, Mainit, Mapula and Kaulangohan in Caibiran, Bool in
			Culaba, Madao, Tucdao and Ungali in Kawayan, Banlas in Maripipi, and
			Anas in Naval, the capital town.

			Teachers slam
			drastic cuts in proposed Duterte 2019 education budget
			By
			Alliance of Concerned
			Teachers
			August 15, 2018
			QUEZON CITY – The
			Alliance of Concerned Teachers lambasted the hefty cuts in the
			proposed education budget of the Department of Budget and Management
			for 2019, saying that the Duterte regime’s purported prioritization
			of human resource development is a “big farce,” as far as education
			budget is concerned.
			“The drastic cuts in the
			proposed education budget for 2019 more accurately mean ‘human
			resource destruction’ than development to teachers, students, and
			the whole nation,” said Raymond Basilio, ACT Philippines
			Secretary-General.
			The DBM-proposed education
			budget is 6.4% or P44.87 billion lower than the approved 2018 budget
			for education. The Department of Education is about to suffer an
			8.9% budget slash which is equivalent to P51.8 billion. It is in
			fact 28% short of what the agency requested. Despite the enactment
			of the Universal Access to tertiary Education Law, budget for State
			Colleges and Universities will still be decreased by .07% or P45.95
			million.
			Basilio expressed dismay
			over DepEd Secretary Briones’ quick retraction of the criticism on
			the looming budget cuts on the agency, saying that “DepEd exposes
			itself as spineless in standing up for the interest of teachers and
			the rest of the education sector.”
			“The cuts spell further
			hardships to education workers on pay and workload, worsening
			shortages on facilities and materials, and greater inaccessibility
			of education to Filipinos,” Basilio stated. Aside from President
			Duterte’s salary increase promise being amiss in the budget,
			personnel services allocation in the education sector will effect
			cuts of P6.4B in personnel benefits and P19.8B decrease in
			allocation for the creation of new teaching and non-teaching items.

			The long overdue increase
			in the allotted special hardship allowance proposed by the
			Department of Education was totally disregarded. Funds for the
			implementation of medical treatment and annual health examination of
			teachers guaranteed in the 1966 Magna Carta, as well as budget for
			benefits under the collective negotiations agreements were
			practically non-existent in the draft budget.
			“It seems this government
			is condemning education workers to slow death. While it wrings us of
			indirect taxes under the TRAIN Law which will fund 39% of the 2019
			budget, it deprives us of our legitimate and legal pay. It denies us
			further of additional teaching and non-teaching personnel
			much-needed to alleviate overwork which has caused the death of our
			colleagues recently,” complained Basilio.
			The proposed budget for
			DepEd and SUCs reflect big slashes in the allocation for facilities
			repair and replacement, procurement and computers, laboratory
			equipment, textbooks and manuals, and construction of new buildings.
			“The cuts are tantamount
			to the further decline of quality and access to education. This is
			destructive to the nation’s human resource, especially the next
			generation. Mr. President, you always say that you cannot just watch
			our youth being wasted on drugs, but by abandoning education, you
			let them go to the dogs!” called out Basilio.
			However, it is remarkable
			how payment of vouchers to private schools remains to be included in
			the top 10 items with the biggest allocation in the budget for
			education, with a P5B increase for DepEd’s SHS Voucher Program to
			private secondary schools.
			“Instead of investing in
			public schools which can accommodate large numbers of pupils for
			years, it would rather hand out public funds to private businesses,”
			noted Basilio.
			The proposed budget will
			effect as well an 84% decrease in budget for all state colleges and
			universities.
			“The Duterte government
			now carries out the paralyzation and the eventual death of SUCs. It
			only goes to show how insincere this regime is in implementing free
			tertiary education,” Basilio concluded.

					|

					District
					Engineer David P. Adongay Jr., (center-right) presiding over
					the staff meeting with Assistant District Engineer Alfredo
					L. Bollido (center-left), Section Chiefs, Unit Heads,
					Project Engineers and Staff on August 9, 2018 at DPWH
					Conference Room. One of the highlights of the meeting is
					regarding on the implementation of 2019 Cash-based budgeting
					System.  |

			Biliran DEO gets
			P1.2B budget for next year based on NEP
			Press Release
			August 13, 2018
			NAVAL, Biliran –
			The Department of Public Works and Highways (DPWH) Biliran District
			Engineering Office (BDEO) has a total allotment budget of P1.2B
			including region wide projects for year 2019 project implementation
			based on National Expenditure Program (NEP).
			David P. Adongay Jr.,
			District Engineer disclosed that out of the allotted amount, the
			district office will only implement P813.9M while P397.9M will be
			implemented by the DPWH Regional Office VIII. This is 30% lower than
			the 2018 General Appropriation Act (GAA) budget amounting to P1.6B.
			Engr. Rosario B. Rosete,
			Chief of Planning and Design Section said that BDEO has 61 total
			proposed projects for 2019 with 56 projects to be implemented by the
			district office.
			Rosete added that out of
			the 56 projects, 12 are already surveyed and three Plans and Program
			of Works (POWs) are already completed. Preliminary and Detailed
			Engineering (PDE) activities are on-going for the remaining
			projects.
			“We can already advertise
			all projects by August this year,” Rosete said.
			According to Adongay, the
			department is rushing all Regional and District Offices to complete
			the detailed engineering activities on projects based on NEP to
			easily implement the same by next year under the cash-based program.
			In 2019, the government
			will be shifting from obligation-based budgeting system to
			cash-based budgeting system which means that implementing offices
			has given only one year to finish all projects based on the
			respective budget allotted.
			“Our aim is 100%
			completion in 2019, although not practical but that is reality,”
			Adongay said.
			“If we want to move ahead,
			we should shift our paradigm,” he added.
			Adongay said that proposed
			projects in NEP are just minimum proposed projects and should expect
			changes for additional projects upon approval of the General
			Appropriations Acts (GAA).

			Go assures AFP of
			PRRD’s full support

			By
			OSAP Media
			August 11, 2018
			CATBALOGAN CITY –
			Special Assistant to the President (SAP) Secretary Christopher
			Lawrence “Bong” Go today assured the Armed Forces of the Philippines
			(AFP) of President Rodrigo Duterte’s full support.

			Visiting this city for the
			celebration of Samar Day, Go went to the Camp Lukban Station
			Hospital to personally check on the condition of three soldiers who
			had been wounded in action.

			“Nagpapagaling na so medyo
			OK na sila (They are recovering already),” Go said. “Hopefully they
			can leave the hospital and go back on duty.”

			He said he will extend
			help if the three soldiers need to continue treatment in Manila.
			“Anything that they need in Manila, the government is willing to
			help them,” he said.

			When Go asked hospital
			doctor Captain Nikaelle Guevara what the Camp Lukban Station
			Hospital needs, the latter replied that they need an x-ray machine
			as well as new hospital mattresses. “You write us a letter, then I
			will immediately follow it up,” Go said.

			He said this is in line
			with President Duterte’s commitment to support the AFP fully. “‘Do
			not worry, full support ko kayo,’” Go quoted Duterte as saying.

			CNTs launch
			pre-dawn raid in Lapinig, N. Samar

			By
			DPAO, 8ID PA
			August 10, 2018
			CAMP LUKBAN, Catbalogan
			City – The Municipal Police Station (MPS) of Lapinig, Northern
			Samar manned by six PNP personnel under PCI Noly Montibon, Chief of
			Police was raided by undetermined number CPP-NPA Terrorists (CNTs)
			onboard two dump trucks and one jeep at around 2:00 A.M. on August
			10, 2018.
			The firefight lasted for
			about 15 minutes that resulted in the wounding of PO1 Edison Aguerre
			and PO2 Jerry Quilicol. The CNTs carted away the following items: 10
			assorted high powered firearms, three handguns, undetermined numbers
			of ammunition/magazine, undetermined numbers of MPS desktop/laptops,
			and the MPS hotline cellular phone.
			It can be recalled that on
			July 13, 2018, Marieta “Tayang” Bartolo, Front Secretary of Metro 1,
			SRC Emporium an NPA unit operating in the municipalities of Pambujan,
			San Roque, Silvino Lobos, Las Navas, Mondragon, and Catarman all of
			Northern Samar and Ruth Martirez Figueroa, Bayan Muna
			President-Northern Samar, an incumbent Barangay Chairwoman of UEP,
			Zone 3, Catarman, N.Samar and three others were apprehended at a
			checkpoint. The Lapinig raid coincided with today’s scheduled
			arraignment of “Tayang” who has two warrants of arrest issued by the
			Gamay Regional Trial Court.
			Maj. Gen. Raul M. Farnacio,
			Commander 8ID condemns the pre-dawn attack conducted by these CNTs
			as a terrorist act against the people of Lapinig, N. Samar.
			In his statement, Maj.
			Gen. Farnacio said that, “It only shows how desperate they are in
			their armed struggle, I urged the community to report to the
			authorities the presence of any armed group in your area. Security
			is a shared responsibility of everyone; it is not just for us, the
			security forces and government institutions but also in
			collaboration with civil society and the communities.”

			Eastern Visayas’
			inflation rate eases to 5.9% in July 2018
			By
			PSA-8
			August 10, 2018
			TACLOBAN CITY – The
			annual Inflation Rate (IR) of Eastern Visayas declined to 5.9% in
			July after posting the record-high 6.3% in June. This IR was 0.4
			percentage point lower compared with the 6.3% IR a month ago, but
			2.7 percentage points higher than the recorded 3.2% IR in the same
			period last year. The regional inflation rate was 0.2 percentage
			point higher than the 5.7% national average in July.
			Four provinces in the
			region – Biliran, Leyte, Northern Samar, and Samar, posted lower
			inflation rates in July with 0.5 percentage point, 0.4 percentage
			point, 1.0 percentage point, and 0.1 percentage point decreases,
			respectively, compared with their figures in the previous month. On
			the other hand, increases were noted in Eastern Samar (0.3
			percentage point) and Southern Leyte (0.1 percentage point). Eastern
			Samar registered the highest IR at 7.8%, while Southern Leyte posted
			the lowest IR at 1.5% (Table 1).
			By major commodity groups,
			Education recorded the highest decrease of a hefty 19.7 percentage
			points, from 3.5% in June to -16.2 percent in July. It posted the
			lowest and the only commodity with negative inflation among all
			commodity groups. This may be attributed to the implementation of
			the free tuition law among State Universities and Colleges.
			Annual price changes in
			Alcoholic Beverages and Tobacco slowed down by 0.4 percentage point
			from its previous month’s rate, but still recorded a double digit
			inflation rate of 21.6%, the highest among all commodities.
			The heavily weighted Food
			and Non-Alcoholic Beverages went up by 0.3 percentage point, from
			7.9% in June to 8.2% during the reference month. This can be
			attributed to faster price increases in rice, corn, fish,
			vegetables, and sugar, jam, honey, chocolate and confectionery
			products. Fish remained to have a double digit inflation at 18.5%,
			the highest among all food items. Communication, meanwhile, recorded
			zero inflation rate in July.
			The Purchasing Power of
			Peso (PPP) of the region remained at P 0.81 in July 2018. This PPP
			implies that goods and services worth 100 pesos in July 2018 only
			costs 81 pesos in 2012.
			All provinces sustained
			their PPP from last month, except Northern Samar, the only province
			that registered a 0.01 centavo increase in the PPP with its figure a
			month ago. Leyte recorded the strongest PPP at P0.84. Southern Leyte
			ranked second at P0.83, followed by Biliran at P0.82, Eastern Samar
			at P0.79, and Northern Samar at P0.77. Samar, meanwhile, posted the
			weakest PPP at P0.76 (Table 1).

			Gov’t workers
			decry planned cut on IRA share
			By
			LEAGUE
			August 10, 2018
			QUEZON CITY – Local
			government employees opposed the proposal of President Rodrigo
			Duterte’s economic managers of lowering the local government units
			Internal Revenue Allotment (IRA) share in favor of the national
			government in response to the recent Supreme Court ruling that the
			IRA must be sourced from “all national taxes and not only internal
			revenue taxes”.
			The IRA amounted to
			P575.52 billion under the proposed 2019 national budget, a far cry
			from the P732 billion IRA if the Supreme Court’s ruling in favor of
			the “just share” of LGUs would be implemented next fiscal year.
			The League of Local
			Government Units Employees (LEAGUE-COURAGE), a federation of LGU
			employees associations and unions, said that social services to the
			people and the security of tenure of rank-and-file employees will be
			the first casualties if the national government decides to reduce
			the allotment.
			“The jobs of LGUs
			project-based employees who have been performing the regular mandate
			of the government would be affected by the cut on the IRA as their
			salaries are sourced from the revenue allotment. Mass lay-off of
			government employees nationwide is imminent if the US-Duterte regime
			decides on the cut on the IRA”, said LEAGUE president Erwin Lanuza.
			“The current LGU and
			national government share of 40%-60% to a possible reduction of
			30%-70% can only be altered if there is an “unmanageable public
			service deficit according to the Local Government Code. If this will
			happen, it will be greatly disadvantageous to LGUs, local
			communities and employees especially in the delivery of much needed
			local social services such as education, health, housing,
			agriculture, water and others, COURAGE National President Ferdinand
			Gaite said.

			He surmised that the
			unmanageable public service debt is actually due to Duterte’s
			adherence to the neo-liberal economic program pushed by US, China
			and other foreign monopoly capital increasing the debt and debt
			service, increasing the AFP and PNP budget, the drive for more
			infrastructure spending under the Build, Build, Build which only
			favor the few. Another impact is that once allotments are reduced
			and funding for local hospitals, schools, housing, water and other
			social services, the privatization of such services (another
			neo-liberal program) will not be far behind leading to more
			expensive services and lay-off of employees.

			Lanuza said that
			government workers, are actually clamoring for the regularization of
			contractuals and have lost faith in Duterte’s promise. Instead, they
			are pushing for the passage of House Bill 7415 file by Bayan Muna
			Representative Carlos Zarate and the Makabayan Bloc which will end
			contractualization and entitle non-regular workers in government
			security of tenure and civil service eligibility. They are also
			pushing for a national minimum wage of P16,000 a month for all
			government employees whether national or local.
